Fort De Soto Park Repairs and Improvements

Project ID
90018G1-A19; 90018G1-A9; 90018G1-A10; 90018G1-A12; 90018G1-A8; 90018G1-A13; 90018G1-A11; 90018G1-A6; 006686A; 004988A; 004093D; 004093E
Project Location
3500 Pinellas Bayway S.
Project Status
Design: In progress
Project Overview
In Fall 2024, Fort De Soto Park suffered significant damage from Hurricane Helene and Hurricane Milton. The damage included extensive flooding that damaged electrical and wastewater systems, boat docks, fishing piers, dune walkovers, seawalls, sidewalks, restrooms, park roadways and the Quartermaster Museum.
Note: This page consolidates multiple projects within Fort De Soto Park that are in various stages of completion.

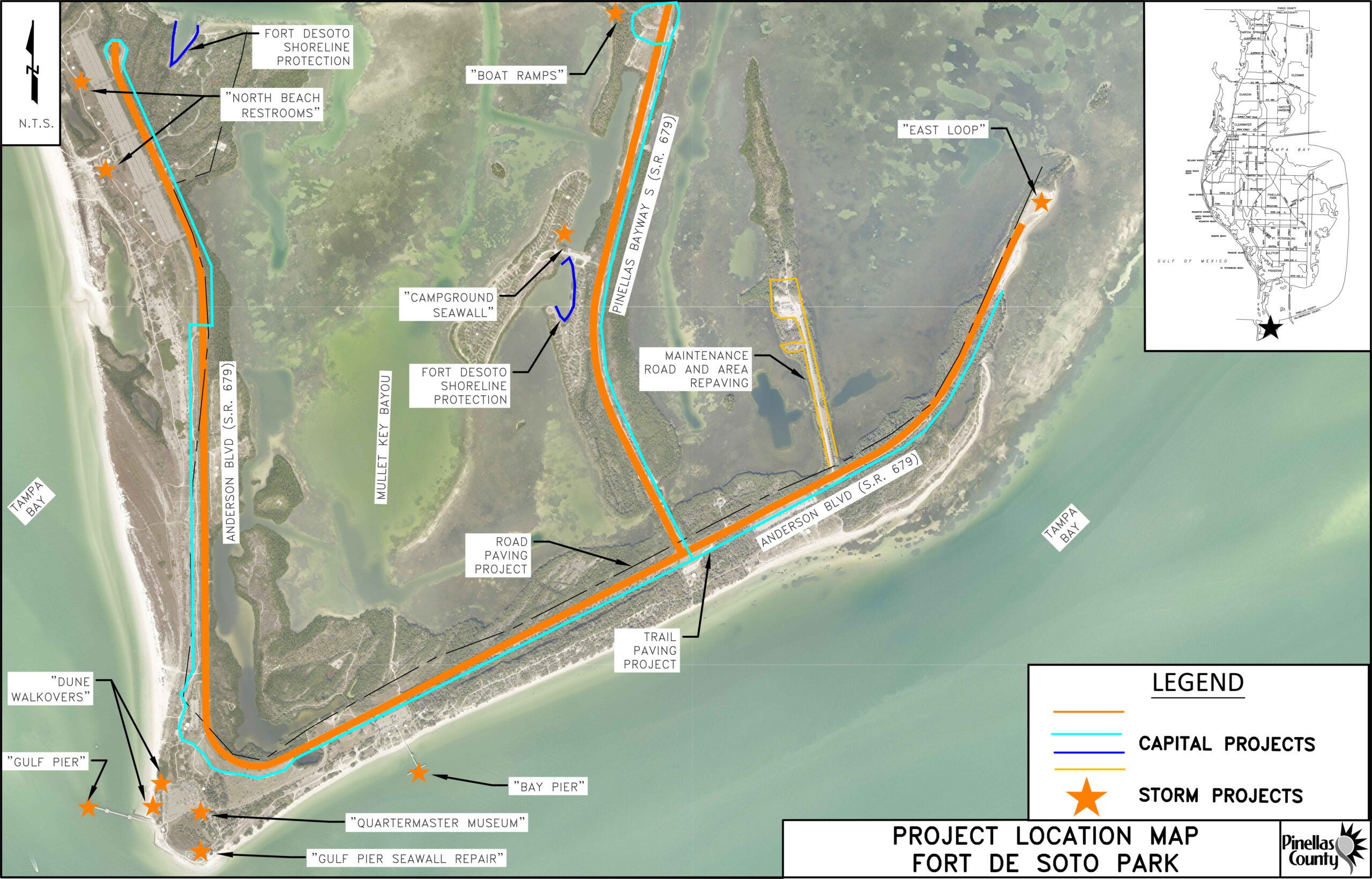

Project Locations

Fort De Soto Boat Docks (PID#90018G1-A19)
The Fort De Soto Boat Docks are located on Madelaine Key in the park. The boat docks were damaged by Hurricane Helene’s storm surge. Gangways, floating docks, railings and concrete abutments were heavily impacted. This project will install new floating docks and gangways in the existing footprints and repair damaged sections of concrete and railing.
Anticipated Schedule: Boat Docks
- Design Completion: Fall 2025
- Construction: Spring 2026 – Summer 2026
Fort De Soto Seawall and Sidewalks (PID#90018G1-A9)
This project will repair and replace the seawall and sidewalk located adjacent to the Gulf Pier as well as repair the washout at the north end of the seawall.
Anticipated Schedule: Seawall & Sidewalk
- Design Completion: Spring 2026
- Construction: Spring 2027
Fort De Soto Bay Pier (PID#90018G1-A10)
The pier was damaged by Hurricane Helene’s storm surge. This project will repair damaged sections of the concrete dock and landings, install replacement gangways/ramps, and replace damaged railings and service lines.
Anticipated Schedule: Bay Pier
- Design Completion: Fall 2025
- Construction: Spring 2026 – Summer 2026
Fort De Soto Quartermaster Museum (PID#90018G1-A12)
The museum consists of a single story, elevated frame structure. The museum was impacted by storm surge and wind during Hurricane Helene. This project will repair the ramp and roof of the building.
Anticipated Schedule: Quartermaster Museum
- Design Completion: Late 2025
- Construction: Summer 2026
Fort De Soto Dune Walkover and Boardwalk (PID#90018G1-A8)
The dune walkover and boardwalk located north of the Gulf Pier were damaged by storms. This project will repair the existing dune walkover by constructing a new walkover in the existing footprint using the existing pilings and repair damaged sections of the northern boardwalk. The waterward end of the south dune walkover will be lowered to the extent possible – while still maintaining Americans with Disabilities Act compliance – to better accommodate the post-hurricane beach elevations.
Anticipated Schedule: Dune Walkover & Boardwalk
- Design Completion: Fall 2025
- Construction: Fall 2025 – Late 2025
Fort De Soto North Beach Restrooms (PID# 90018G1-A13)
This project will repair the restrooms to pre-hurricane conditions, including screen walls and floors.
Anticipated Schedule: North Beach Restrooms
- Design Completion: Late 2025
- Construction: Summer 2026
Fort De Soto Campground Seawall (PID# 90018G1-A11)
This project will replace sections of the aluminum seawall behind the campsites to ensure the safety of campers and to prevent additional erosion. The new seawall will be placed in front of the failed wall.
Anticipated Schedule: Campground Seawall
- Design Completion: Spring 2026
- Construction: Summer 2026 – Winter 2026
Fort De Soto East Beach Loop (PID# 90018G1-A6)
The northeast end of Anderson Boulevard (Mullet Key) was impacted by Hurricane Helene. The storm damaged the roadway, removing roadway base and broke off portions of the travel lanes. This project will repair and reconstruct the traffic circle to pre-hurricane conditions.
Anticipated Schedule: East Beach Loop
- Design Completion: Late 2025
- Construction: Spring 2026 – Late 2026
Fort De Soto Shoreline Protection (PID# 006686A)
This project will improve the shoreline at two locations within the park where the seawall is failing; the Campground area and Bunces Pass Cove. In the two project areas, failing sections of the seawall will be reconstructed using resilient approaches that integrate natural practices where possible. These shoreline improvements are also expected to support healthier ecosystems, enhance water quality, and create new opportunities for recreation.
Anticipated Schedule: Shoreline Protection
- Design Completion: Late 2026
- Construction: Summer 2027 – Late 2027
Fort De Soto Main Road Paving (PID# 004988A)
This project will repave approximately 7 miles of roadways. Roadway repaving will extend from the south approach of the Bayway Bridge, along Pinellas Bayway South, and the length of Anderson Boulevard terminating at the east end of Anderson Boulevard.
Anticipated Schedule: Main Road Paving
- Design Completion: Late 2025
- Construction: Spring 2026 – Late 2026
Fort De Soto Trail Paving (PID# 004093D)
This project will repave approximately 6.6 miles of trail along Pinellas Bayway South and Anderson Boulevard at Fort De Soto Park. A connection to Anderson Boulevard near East Beach will be added at the northeastern terminus of the trail.
Anticipated Schedule: Trail Paving
- Design Completion: Late 2025
- Construction: Spring 2026 – Spring 2027
Fort De Soto Maintenance Area Paving (PID# 004093E)
This project will repave approximately 0.5 miles of roadway serving Fort De Soto Park’s maintenance area, one driveway, and approximately 3 acres of parking and work areas at the maintenance headquarters.
Anticipated Schedule: Maintenance Area Paving
- Design Completion: Fall 2026
- Construction: Spring 2027 – Winter 2027
Project Funding
Storm repair projects will be partially funded through FEMA and the Florida Division of Emergency management. Eligible repair costs will be funded at a 75% federal cost share, 12.5% state cost share, and 12.5% County cost share on a reimbursement basis. The paving projects are supported by Penny for Pinellas. The shoreline protection project is supported by the Surface Water Utility Fund and the Penny for Pinellas.
